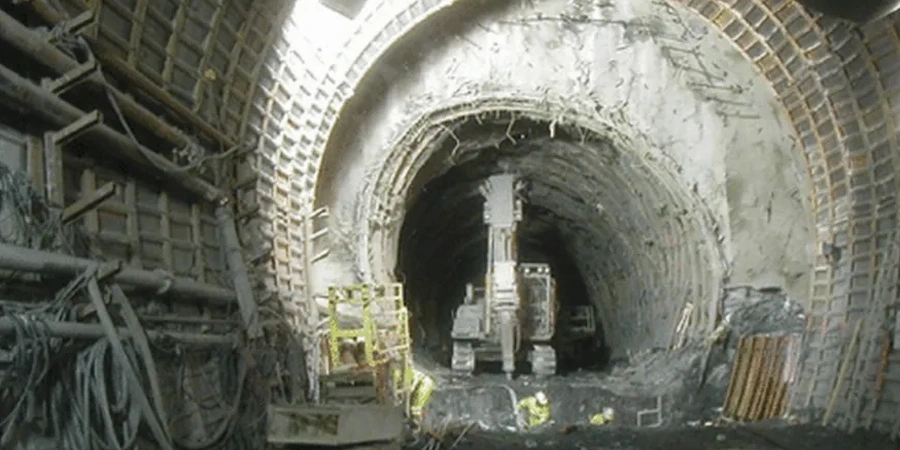

Geotechnical Analysis for Soft Ground Tunnels in Bakersfield

Bakersfield sits at the southern end of the San Joaquin Valley, where the Kern River has deposited centuries of interbedded silts, clays, and loose sands across the basin. Anyone opening a tunnel section here quickly learns that the groundwater table sits unusually high for an arid region—often within 3 to 5 meters of the surface—and that the alluvial deposits lack the cohesion of the weathered rock found up in the Tehachapi foothills. This combination of shallow water and low-strength overburden means that soft ground tunneling in Bakersfield demands a geotechnical analysis that goes well beyond standard SPT blow counts. We typically couple our investigation with CPT soundings to capture continuous tip resistance and pore pressure profiles, because the interlayered stratigraphy in the Kern County fan complex is too variable for discrete sampling alone. The city’s warehouse and logistics expansion along the 99 corridor has increased demand for shallow utility and drainage tunnels, and every project we have reviewed reinforces the same lesson: pre-construction characterization of the soil matrix, undrained shear strength, and consolidation behavior is the difference between a controlled drive and a costly surface depression.

In Bakersfield’s alluvial fan, a stiff surface clay can hide a loose saturated sand lens less than a meter below—a condition that demands continuous CPT profiling, not just discrete SPT sampling.

Methodology and scope

One pattern we observe repeatedly in Bakersfield is that the near-surface ‘B-horizon’—a stiff silty clay cap that looks competent in a test pit—can mask a loose saturated sand lens only a meter below. When a tunnel boring machine breaks into that lens without adequate face support, the working chamber can lose pressure almost instantly, triggering a chimney collapse that propagates to the street above. Our characterization protocol for soft-ground tunnels therefore includes a dense grid of SPT borings advanced at least two tunnel diameters below the invert, combined with laboratory consolidation and triaxial CU tests on undisturbed Shelby tube samples. The objective is not merely to classify the soil per ASTM D2487 but to construct a solid constitutive model—typically a hardening-soil or Cam Clay parameter set—that the contractor’s engineer can import directly into a 2D or 3D finite-element analysis. In Bakersfield’s finer alluvium, we also run Atterberg limits on every major stratum change; plasticity indices above 25 often signal swelling potential that can distort segmental lining rings months after ring build. For deeper crossings near the Kern River paleochannel, we supplement the investigation with seismic refraction lines to map the bedrock profile and identify paleo-scour features that could concentrate groundwater flow around the tunnel crown, a local hazard that standard borehole logs frequently miss.
Geotechnical Analysis for Soft Ground Tunnels in Bakersfield

Local considerations

The most frequent mistake we see in Bakersfield is a contractor treating the local alluvium like a homogeneous medium and specifying a uniform face pressure for the entire drive. In reality, the Kern River fan contains abrupt transitions—from stiff clay to running sand—over distances of less than 30 meters, and a face pressure optimized for the clay will be dangerously low when the cutterhead enters the sand. The result is a rapid loss of confinement, over-excavation, and a settlement trough that can damage pavement, buried utilities, or adjacent warehouse slabs before the operator can react. A second common failure mode involves underestimating long-term consolidation settlement below the tunnel invert; even if the immediate volume loss is controlled, slow drainage from the disturbed clay zone can produce additional settlement of 15 to 30 mm over the first 18 months, enough to crack rigid connections in a drainage tunnel. A properly scoped geotechnical analysis must quantify both the short-term face stability and the time-dependent consolidation, using staged oedometer tests on the compressible layers that will be stressed by the permanent lining loads.

Need a geotechnical assessment?

Reply within 24h.

Email: contact@geotechnicalengineering1.com

Applicable standards

ASTM D1586-18 (Standard Penetration Test), ASTM D2487-17 (Unified Soil Classification), ASTM D5778-20 (CPT), FHWA-NHI-09-010 (Technical Manual for Design and Construction of Road Tunnels), IBC 2021 Chapter 18 (Soils and Foundations), ASCE 7‑22 (Minimum Design Loads)

Associated technical services

01

Tunnel Face Stability and Settlement Analysis

We develop a ground model using SPT, CPTu, and triaxial testing to calculate the limiting support pressure at the tunnel face and predict the three-dimensional settlement trough. The analysis follows the wedge and chimney stability framework outlined in FHWA-NHI-09-010 and is calibrated with local Bakersfield case data so the contractor can set EPB or slurry parameters with confidence.

02

Pre-Construction Ground Improvement Design

Where the alluvial soils are too weak for open-face tunneling, we design pre-treatment schemes—compaction grouting, permeation grouting, or dewatering well arrays—based on in-situ permeability tests and grain-size distributions. The design is integrated with the tunnel alignment to minimize the treated volume while ensuring a minimum factor of safety of 1.5 against face collapse during excavation.

Typical parameters

ParameterTypical value
Minimum boring depth below tunnel invert2 × tunnel diameter (D), with at least one boring to 3D at each shaft location
Undrained shear strength (Su) in soft clay units15–45 kPa, confirmed by field vane or triaxial UU/CU tests per ASTM D2850
In-situ horizontal stress coefficient (K₀)Estimated from CPTu friction ratio and OCR, typically 0.55–0.75 in normally consolidated valley alluvium
Groundwater monitoring frequencyContinuous piezometer readings over a minimum 6‑month wet-dry cycle before face pressure design is finalized
Consolidation parameters (Cc, Cr)Cc = 0.18–0.35; Cr = 0.02–0.05, determined by incremental loading oedometer per ASTM D2435
Face support pressure window (EPB)0.8–1.3 bar above hydrostatic, tuned to limit surface settlement to ≤ 25 mm
Settlement trough width parameter (i)i ≈ 0.45Z₀ for sands, 0.55Z₀ for silty clays (Z₀ = tunnel axis depth), calibrated with local case histories

Frequently asked questions

What is the typical cost range for a geotechnical investigation for a soft-ground tunnel in Bakersfield?

For a tunnel project in Bakersfield, the geotechnical investigation typically ranges from US$4,800 for a limited campaign with a few SPT borings and basic lab tests, up to US$16,760 for a comprehensive program that includes CPTu soundings, triaxial and consolidation testing, piezometer installation, and a full interpretive report with numerical modeling parameters. The final cost depends on the tunnel length, depth, and how variable the alluvial stratigraphy is along the alignment.

Which soil units in Bakersfield cause the most difficulty during tunnel excavation?

The loose saturated sand lenses interbedded within the Kern River alluvium are the most problematic. These units have little to no stand-up time and can flow into the cutterhead if face pressure is not carefully maintained. The overlying stiff silty clay can also create a false sense of security until the TBM breaks into the sand below, which is why we emphasize continuous CPT profiling to map these transitions before the drive begins.

How do you account for the high groundwater table in Bakersfield’s tunnel design?

We install vibrating-wire piezometers at multiple depths along the alignment and monitor them through at least one full wet-dry season. The pore pressure data is used to define the hydrostatic baseline for face pressure calculations. In areas where the groundwater is within one tunnel diameter of the crown, we evaluate dewatering feasibility or recommend a closed-mode EPB operation with a pressurized working chamber to prevent water inflow and face instability.

What laboratory tests are essential for Bakersfield’s alluvial soils?

Beyond standard index tests, we run consolidated-undrained (CU) triaxial tests with pore pressure measurement on undisturbed Shelby tube samples from each major stratum, incremental loading oedometer tests to obtain compression and recompression indices, and Atterberg limits to identify expansive clay layers. These results feed directly into the constitutive soil model used for the tunnel finite-element analysis.

How long does a typical tunnel geotechnical investigation take in Kern County?

A full investigation for a soft-ground tunnel in Bakersfield generally takes between six and ten weeks. Fieldwork—drilling, CPT soundings, and piezometer installation—accounts for the first three to five weeks. The remaining time is dedicated to laboratory testing and the preparation of the geotechnical interpretive report, which includes the ground model, design parameters, and settlement predictions.
